Gnangara Road Duplication

The construction of the second carriageway for Gnangara Road between Henley Brook Avenue and Pinaster Parade. This is a multi-stage project that will be delivered over multiple financial years.

Project status

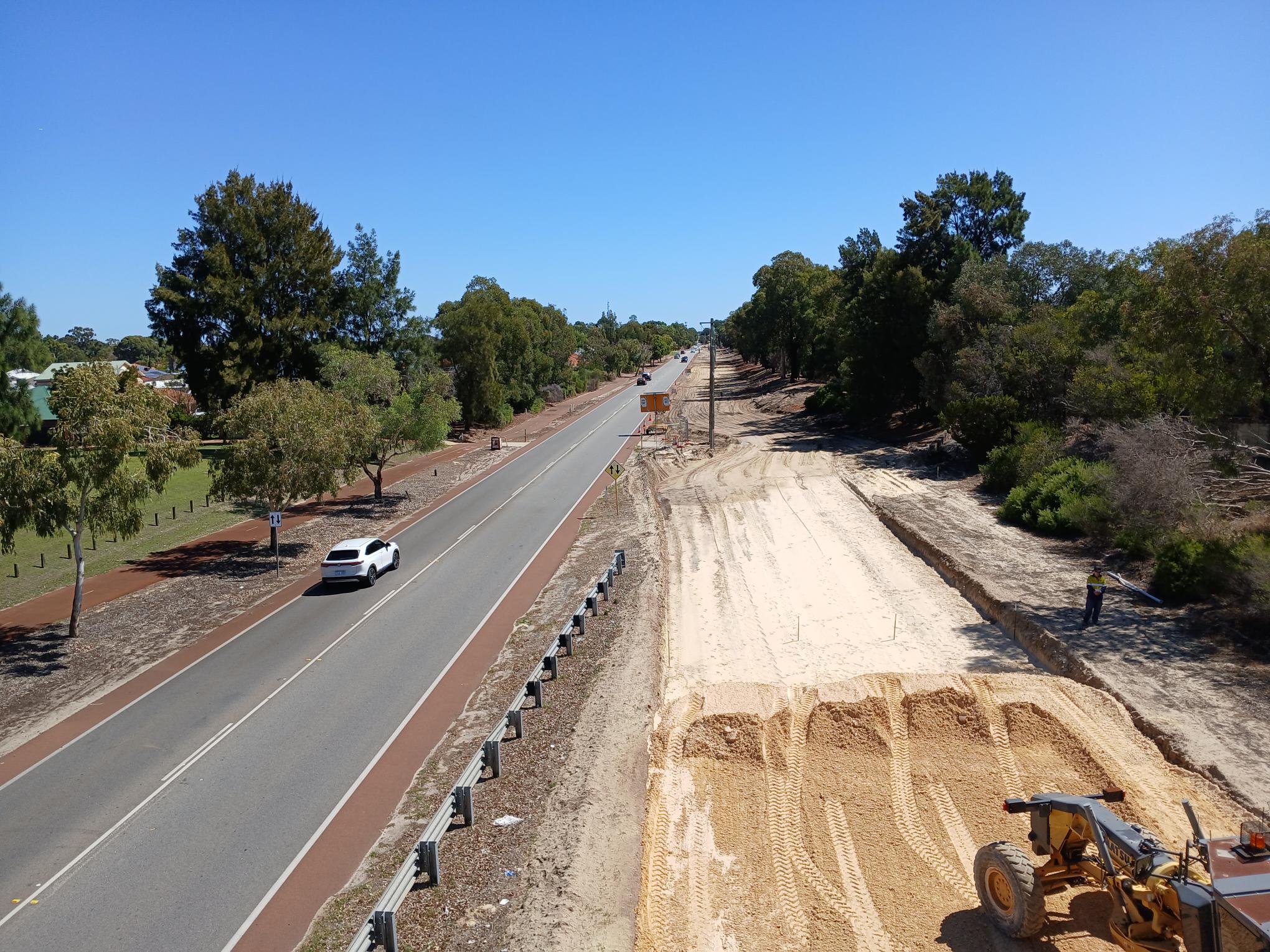

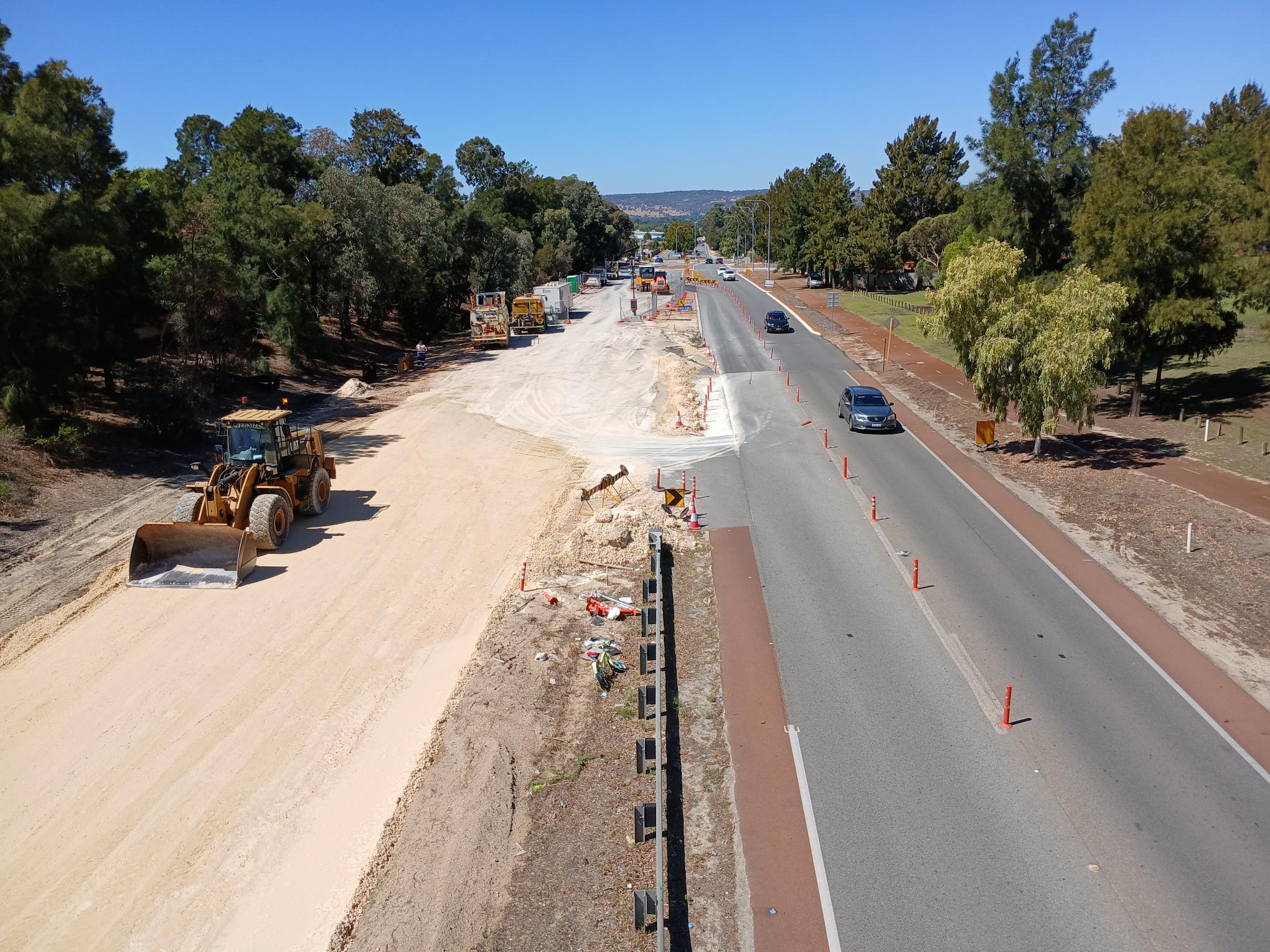

Construction is currently underway, with the northern carriageway completed and open to traffic. Works on the southern carriageway are progressing, with the next stage involving the reconstruction of the Gnangara Road/Losino Boulevard intersection. Both carriageways are expected to be open to traffic by October 2026. Remaining finishing works, including the installation of street lighting, line marking and signage, will be undertaken by others and are not expected to require road closures.

Project timeline

Community consultation

Completed in January 2023

Planning and design

Started in 2023/24 and currently ongoing.

Service relocations

Ongoing – some utility services will occur concurrently with the road works

Construction starts

February 2025

Construction finishes

Scheduled for October 2026.

FAQ's

Due to an increase in urban development in the urban growth corridor, duplication is needed to support the increase in traffic. This duplication will link to previously duplicated segments to the east and west.

For several reasons, the Gnangara Road duplication is a major project staged over three financial years. Factors such as grant funding, service relocations and construction resources mean it is not feasible for the City to complete the project in one financial year.

Losino Boulevard needs to be temporarily closed to allow reconstruction of the Gnangara Road/Losino Boulevard intersection as part of the duplication project. The work involves rebuilding the road, drainage, kerbs, medians, footpaths, and utilities. During construction, the area won’t be safe or suitable for traffic, so vehicle access can’t be maintained.

A full closure is needed to keep road users, pedestrians and workers safe during major construction works.

The work involves deep excavation, rebuilding the road, installing drainage, and using heavy machinery and trucks, which makes it unsafe to allow traffic through the area and impractical to open and close the road frequently.

Losino Boulevard is also a busy road, with about 2,740 vehicles each weekday, including heavy trucks. Keeping it open during these works would create serious safety risks.

Access has been maintained as long as possible:

  • June–Dec 2025: Fully open
  • Jan–July 2026: Left-in/left-out access only
  • July–Oct 2026: Full closure.

The full closure is now required because the intersection itself needs to be completely rebuilt.

The City looked at options to keep the road open, including shorter closures and staged works.

However, these options were not suitable because they would/p>

  • Increase safety risks for workers and road users
  • Take longer to complete
  • Cost more due to extra traffic management
  • Increase the risk of damage and rework
  • Reduce the overall quality of the finished road.

A single closure is the safest, fastest and most efficient way to complete the work.

The 14-week period is the maximum expected time needed to complete the remaining work, including allowances for weather, site conditions and other risks.

If work progresses smoothly, the intersection may reopen earlier, with final finishing works completed under partial lane closures.

The project is on schedule and partly funded by the Federal Government.

Delaying the closure would disrupt the overall timeline, extend construction in the area, and could affect funding, contracts, and planned completion dates.

Yes. Residents will still be able to access their properties throughout the closure, and no direct property access will be affected.

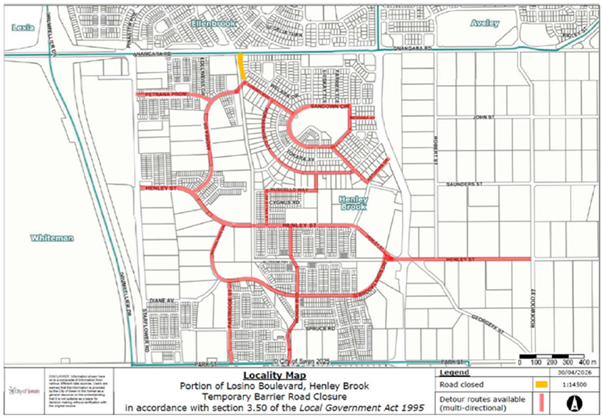

Alternative routes in and out of Henley Brook and Morgan Fields will remain available and are shown in the project plans.

Yes.

Traffic on nearby roads is expected to increase during the closure, but the City has reviewed the network and believes it can manage the additional vehicles. Local roads in urban areas are generally designed to handle this level of traffic.

The City will monitor conditions during construction and adjust if needed.

The City used several methods to inform the community, including:

  • Sending around 600 letters to residents and property owners
  • Advertising in the local newspaper
  • Displaying public notices at City buildings and libraries
  • Sharing information on the City’s website and social media
  • Notifying key stakeholders and emergency services

Information was also shared informally through local community networks and word of mouth.

The City understands the temporary closure will be inconvenient and has worked to minimise impacts where possible.

Access has been maintained throughout most of the project:

  • Gnangara Road has remained open
  • The intersection stayed fully open until December 2025
  • Left-in/left-out access has been provided since January 2026

The full closure is only being introduced now because the intersection must be rebuilt and it’s no longer possible to keep it open safely.

The closure is necessary to complete the works and deliver long-term benefits from the project.

The current level of streetlighting is temporary and reflects the lighting that existed before construction started.

As part of the Gnangara Road Duplication Project, new streetlighting will be installed in the median along the full length of Gnangara Road between Pinaster Parade and Henley Brook Avenue. This permanent lighting will be delivered as part of the road upgrade works.

During construction, temporary lighting has been provided at key intersections including:

  • Gnangara Road and Pinaster Parade
  • Gnangara Road and Losino Boulevard
  • Gnangara Road (west of Henley Brook Avenue).
These temporary arrangements are in place until the permanent lighting infrastructure can be installed.


The total project budget is $12.25 million, including:
$8.75 million from the Australian Government
$3.5 million from the City of Swan.

Construction is currently progressing within the approved budget, and projected spend is being closely monitored. At this stage, the City expects to complete the project within the allocated funding, subject to the successful completion of the remaining works.


Yes. The anticipated completion date of October 2026 is not a recent change and has been the expected timeframe communicated for the project.

While early works began in 2025, the main road construction works did not start until June 2025, after essential utility relocation works were completed. The overall construction program for the project is about 18 months, which is typical for a project of this scale and complexity.

Construction timelines are influenced by a range of factors, including:
  • Utility relocations
  • Traffic management requirements
  • Staged construction to maintain access for road users
  • Weather conditions
  • Availability of materials and contractors.

The project is currently progressing as planned and remains on track for completion in October 2026.
